Parks

Parks

Meet community need for parks, open space, and outdoor amenities.

  • Goal 1: Maintain and update existing parks, open space, and amenities.
  • Goal 2: Address open space and amenity deficiencies and equitability.
  • Goal 3: Provide new recreational opportunities to respond to community needs.

Tactic 1: Complete Glos Park site improvements (Targeted Completion Date-May 2022)

Project Background

  • Background: Serving the Elmhurst downtown area, Glos Park provides park open space and formal gardens in this densely populated area.
  • Need and Benefits: By demolishing the building on the adjacent property at 135 Palmer Drive (acquired in 2016), the District has the opportunity to increase park open space and amenities for the neighborhood. The Palmer Drive building is in poor condition as illustrated in an independent facility assessment by Dewberry Architects.
  • Cost: The Park Board budgeted $675,853 to hire the landscape architecture firm, Upland Design, to create a development plan for an expanded Glos Park (based on public feedback) and other firms to demolish the building and parking lot and complete site improvements.
  • Funding: Developer donations accrued in previous fiscal years ($675,853).
  • Timeline based on a realistic construction schedule:
    • ​Spring/Summer 2021: Community feedback and project planning
    • August 2021: Demolition of 135 Palmer Drive building
    • Fall 2021: Project bid process and approval and begin construction
    • Winter/Spring 2022: Construction continues with a targeted completion in spring

Progress Update

  • Park Board approved hiring of Upland Design for landscape architect/engineering services to develop the Glos Park expansion Master Plan (Winter 2021)
  • Park Board approved hiring Midwest Environmental Consulting Services, Inc. to abate all hazardous materials and oversee the removal of an underground storage tank at the 135 Palmer Drive building (Spring 2021)
  • Held a community open house (5/3/2021) to gather feedback on three concepts and potential amenities for the new park open space (46 participants) (Spring 2021)
  • Conducted community survey in early May 2021 to gather additional input on the three concept plans and potential new amenities (605 respondents) (Spring 2021)
  • Presented draft master plan concept to the community at a second open house (6/17/21) (26 participants) (Spring 2021)
  • Park Board reviewed and approved draft master plan on June 28, 2021 (Summer 2021)
  • Midwest Environmental Consulting Services, Inc. completed building abatement and final air testing (Summer 2021)
  • R W Collins Company removed a 6,000 gallon heating tank from the property, transported it off site, and properly disposed its contents and contaminated soils (Summer 2021)
  • Park Board approved contract for Fowler Enterprises LLC to provide building demolition services (Summer 2021)
  • Fowler Enterprises LLC demolished building, removed adjacent parking lot, and backfilled and graded site (Summer and Fall 2021)
  • Upland Design surveyor completed topographic survey to develop construction drawings based on Master Plan and site elevations (Fall 2021)
  • Purchased pergola (in the approved Master Plan for expanding the park) early due to projected price increases (from steel pricing volatility) (Fall 2021)
  • Posted bid legal, began accepting bids, and eight (8) contractors attended the mandatory pre-bid meeting (1/11/2022) (Winter 2022)
  • Park Board awarded expansion project construction services to Hacienda Landscaping, Inc.  ($206,531) (Spring 2022)
  • Hacienda Landscaping, Inc. began site excavation to start construction, including excavated paths and curbs to prepare for concrete installation, and poured concrete pads for benches and footings for the pergola (Spring 2022)

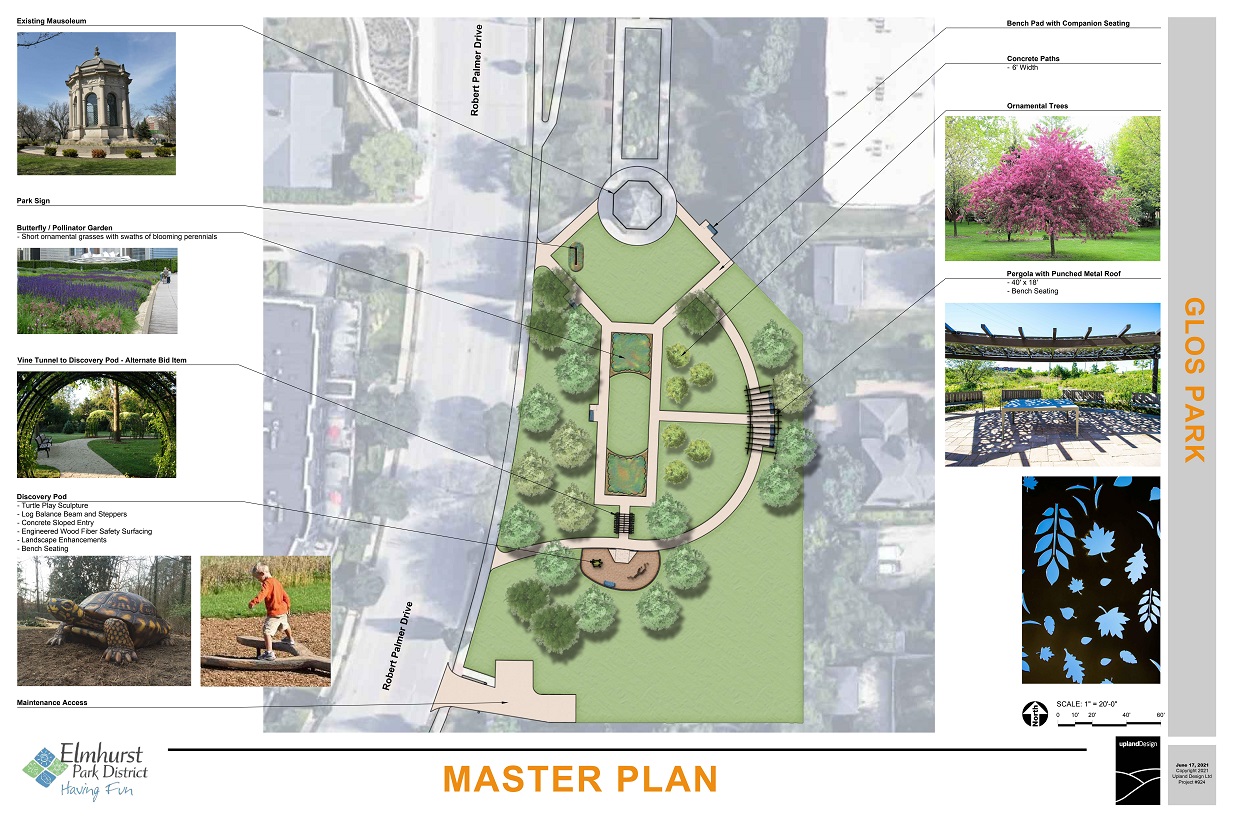

Glos Memorial Park approved Master Plan (click to enlarge)

Glos Memorial Park construction

Tactic 2: Complete construction of a neighborhood park at Centennial Park (Targeted Completion Date-May 2022)

Project Background

  • Background: Along with renovating the new Adult Center building at Centennial Park (155 E. St. Charles Road), the District is redeveloping the adjacent park open space in 2021.
  • Need: As part of the Vision 2020 park level of service analysis, the planning area for this neighborhood was identified as a high land acquisition priority due to the lack of access to park space and amenities such as a playground. According to the Vision 2020 Plan, 36% of residents do not have access to a neighborhood park within a half mile of their home. Centennial Park meets this need for this neighborhood.
  • Benefits: By improving the site, the District will expand park offerings and the level of services provided to the neighborhood and users of the Adult Center and improve equity across the community regarding access to park amenities. The new park would also enhance the quality of life of the neighborhood due to its environmental and social benefits.
  • Cost: The total budget for this project is $900,000. Project costs include working with Upland Design, a landscape architecture firm, to create a park master plan based on public feedback along with engineering, design, and construction expenses to develop the site.
  • Funding: In 2022, the District will fund the project utilizing $503,600 of The Abbey sale proceeds ($196,400 in 2021) and $200,000 of Special Recreation Association Fund reserves for accessibility improvements.
  • Timeline based on a realistic construction schedule:
    • Spring/Summer 2021: Community feedback and project planning
    • Fall 2021: Project bid process and approval and begin construction
    • Winter/Spring 2022: Construction continues with targeted completion in Spring

Progress Update

  • Park Board approved hiring of Upland Design for landscape architect/engineering services to develop Centennial Park Master Plan (Winter 2021)
  • Held community open house (4/22/2021) to gather feedback on potential amenities to shape park plan concepts (over 50 participants) (Spring 2021)
  • Based on feedback, Upland Design developed park concept plans and gathered additional feedback at second community open house on May 27, 2021 and via an online community survey with 683 responses (Spring 2021)
  • Based on the second community open house and survey feedback, Upland Design developed a draft master plan (Spring 2021)
  • Park Board reviewed and approved the draft master plan on June 28, 2021 (Summer 2021)
  • Purchased and received playground equipment and park shelter early due to anticipated price increases and to avoid supply chain back-ups (Summer and Fall 2021)
  • Completed project engineering and design (overseen by Upland Design), along with the project bid process (Summer and Fall 2021)
  • Held mandatory on-site pre-bid meeting (10 contractors attended) (Fall 2021)
  • Park Board awarded the Centennial Park construction project to E. Hoffman Inc. (Fall 2021)
  • Completed City of Elmhurst's Planned Unit Development Process for Adult Center/Centennial Park site, including presenting the concept plan to the City's Development, Planning and Zoning Committee and Zoning and Planning Commission along with holding a public meeting at the site (Fall 2021)
  • Elmhurst City Council approved the Planned Unit Development application, including an Ordinance granting a Conditional Use permit (Fall 2021)
  • E. Hoffman Inc. completed site excavation to start construction, including: (Spring 2022)
    • removed existing sidewalks and installed new sidewalks to create three access points to enter play area;
    • poured colored concrete for the fountain geyser and shelter area;
    • installed playground, adult fitness equipment, and safety surfacing; and
    • began to plant and install trees and performed additional grading to create berms.
  • Construction completed (Spring 2022)

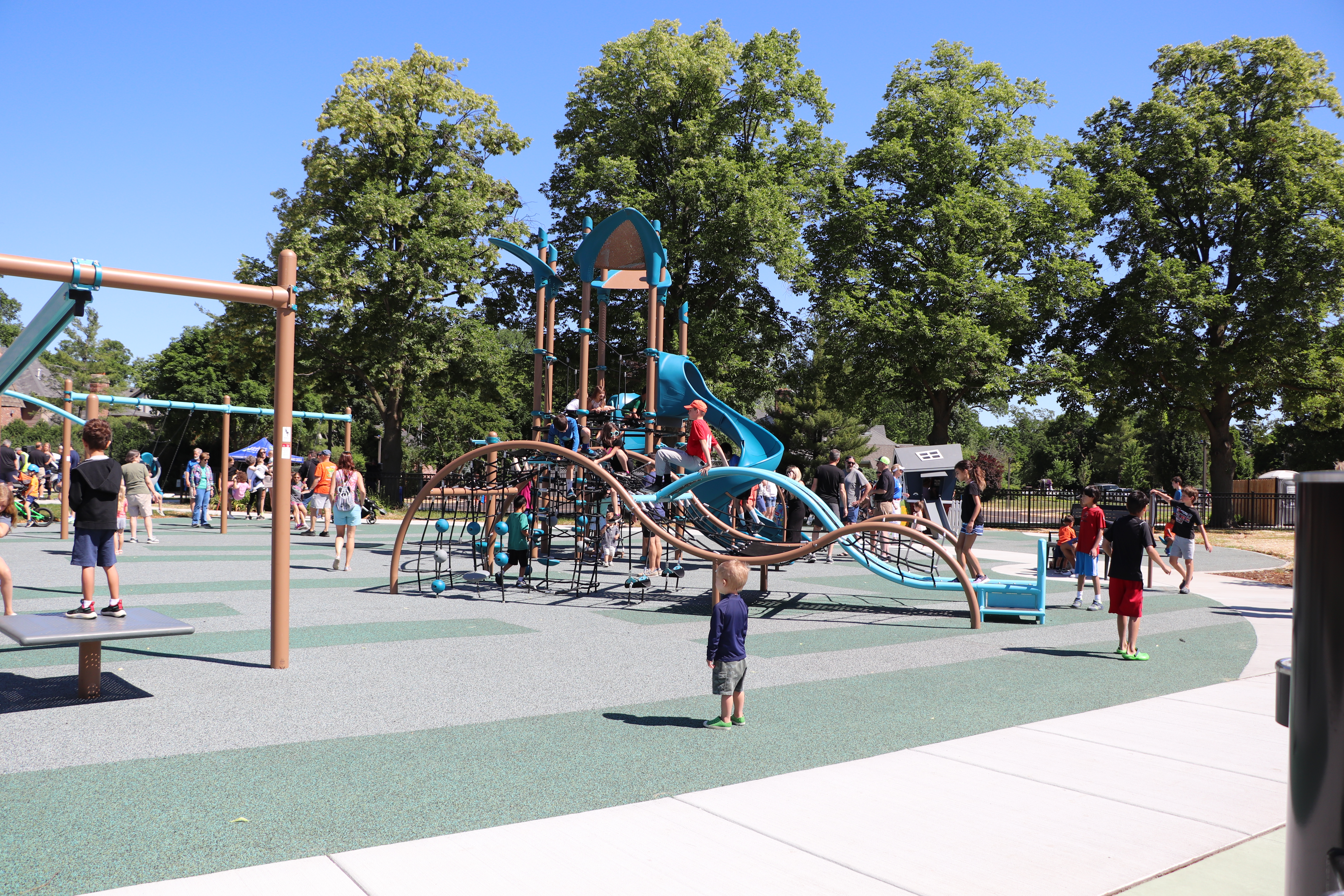

  • Held Grand Opening on June 18 and playground opened to the public (Spring 2022)

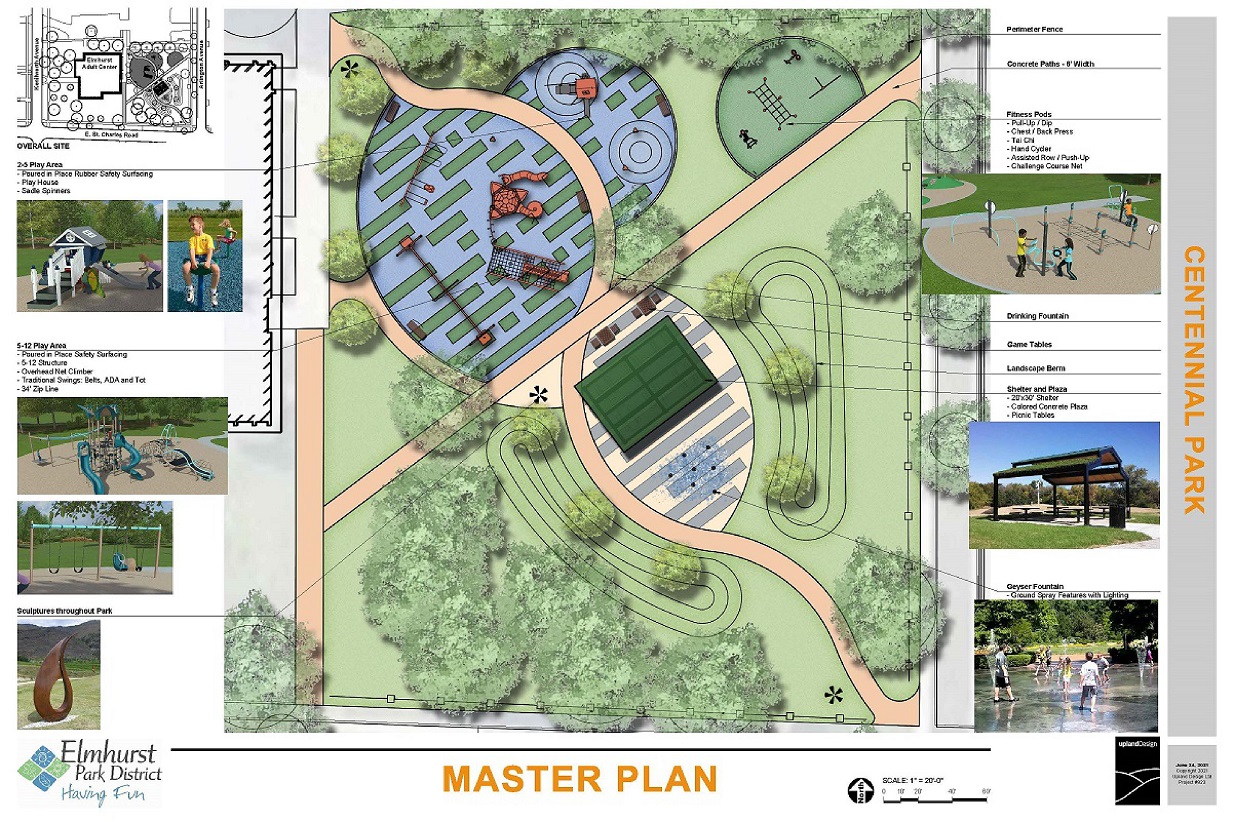

Centennial Park Master Plan (click to enlarge)

Centennial Park construction

Centennial Park opening and ribbon cutting

Tactic 3: Redevelop Eldridge Park east play area and pathways (Targeted Completion Date-October 2022)

    Project Background

  • Background: The Eldridge Park east playground was due to be replaced in 2020 per the District’s playground replacement schedule, but was postponed in 2020 and 2021 due to pandemic related financial constraints.  The playground and surface were originally installed in 2000 and have now reached the end of their useful life.
  • Need and Benefits: By redeveloping Eldridge Park east play area and pathways, the District can upgrade outdated equipment (incorporating continued compliance to current safety standards), address deficiencies identified in the District’s Americans with Disabilities (ADA) Act Plan, and address the Vision 2020 park assessment deficiencies (playground received a score 78 out of 100).
  • Cost: The Park Board approved $475,000 in the 2022 Budget for the completion of this project (replace the playground equipment, refurbish asphalt pathways, and resurface the parking lot).
  • Funding: Park Board approved utilizing the SRA Fund ($200,000 to address accessibility improvements) and General Fund ($275,000) reserves to cover project costs.
  • Timeline based on a realistic construction schedule:
    • Spring, Summer, and Fall 2019: Completed community feedback and project planning
    • Winter 2020: Park Board approved playground concepts
    • 2020 and 2021:  Project postponed due to pandemic related financial constraints
    • Winter 2022: Park Board approved project construction bid
    • Summer and Fall 2022:  Begin and complete construction

     Progress Update

  • Conducted in-person surveys at Eldridge Park to gather feedback (Spring and Summer 2019)
  • Held Party in the Park input meeting (approximately 60 people attended) (Summer 2019)
  • Conducted online survey to collect community input on initial playground concepts (Fall 2019)
  • Park Board approved playground concept including many features the community requested, including more climbing equipment, swings, seating and shade structures (Winter 2020)
  • Postponed project due to pandemic related financial constraints and approved project funding in 2022 Budget (2020 and 2021)
  • Park Board approved purchasing the playground equipment and site furnishings to avoid supply chain delays and volatile pricing (Winter 2022)
  • Held mandatory pre-bid meeting (11 contractors in attendance) (Winter 2022)
  • Park Board awarded construction services of $142,570 to Hacienda Landscaping, Inc. (Spring 2022)
  • Kids Around the World, a non-profit organization, removed the existing playground equipment to refurbish and reinstall it for an underserved community either in the United States or globally (Spring 2022)

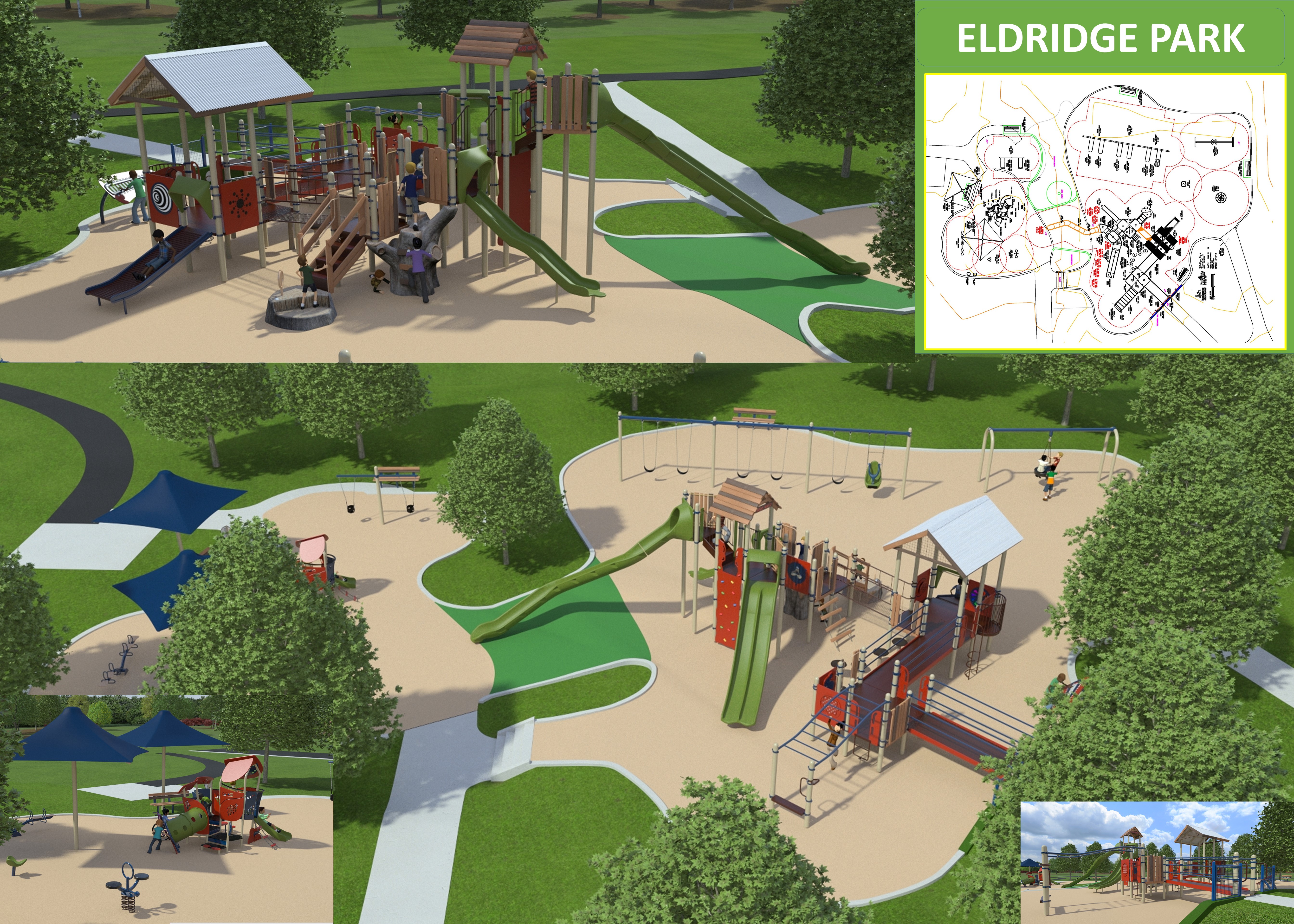

Eldridge Park east playground approved concept (click to enlarge)

Tactic 4: Restore Sugar Creek Golf Course creek (Targeted Completion Date-March 2024)

Project Background

  • Background:  The Sugar Creek Golf Course creek is compromised by streambank erosion, loss of property, sediment accumulation, water quality degradation, and irrigation pond deterioration. To address these issues, the Creek needs an environmentally sound stream stabilization, pond improvements, and riparian corridor enhancements plan.
  • Need and Benefits:  By addressing these issues the District will avoid additional costs for irrigation upon failure of the current system and the need to change or possibly close up to five golf holes due to unsafe shorelines.
  • Cost:  Initial project total cost estimated at $1,225,000.
  • Funding: 50% will be funded by grants ($672,515) and 50% ($552,485) will be funded equally by the Sugar Creek Golf Course, Village of Villa Park and the Elmhurst Park District. Before grant funding is disbursed after project completion, the entire project cost must be funded by the three entities.
  • Timeline based on a realistic construction schedule:
    • 2018-2022: Apply for grants
    • Fall 2022-Spring 2023: Construction timeline
    • Summer 2023: Construction targeted completion

Progress Update

  • Park Board approved project to restore the eroding Sugar Creek (Summer 2018)
  • Worked with Living Waters Consultants, Inc. on grant submittals, final engineering, and permit applications (Fall 2018)
  • Received $47,000 grant through the National Fish and Wildlife Foundation Five Star and Urban Waters Restoration Program (Fall 2019)
  • Living Waters Consultants, Inc., completed final engineering plans (Spring 2020)Notified by DuPage County that $60,000 of grant funding was approved through the Water Quality Improvement Program (Spring 2021)
  • Notified by the Illinois Environmental Protection Agency (IEPA) that grant funding was approved for approximately 50% of the restoration project cost ($612,515) (Fall 2021)
  • Entered into an agreement with Living Waters Consultants, Inc. to perform bidding, construction observation and grant administration services (Winter 2022)
  • Park Board approved an Intergovernmental Agreement between DuPage County, Village of Villa Park and Elmhurst Park District outlining each agencies responsibilities and funding and cost obligations (Winter 2022)
  • Held mandatory pre-bid meeting (6 contractors attended) (Spring 2022)

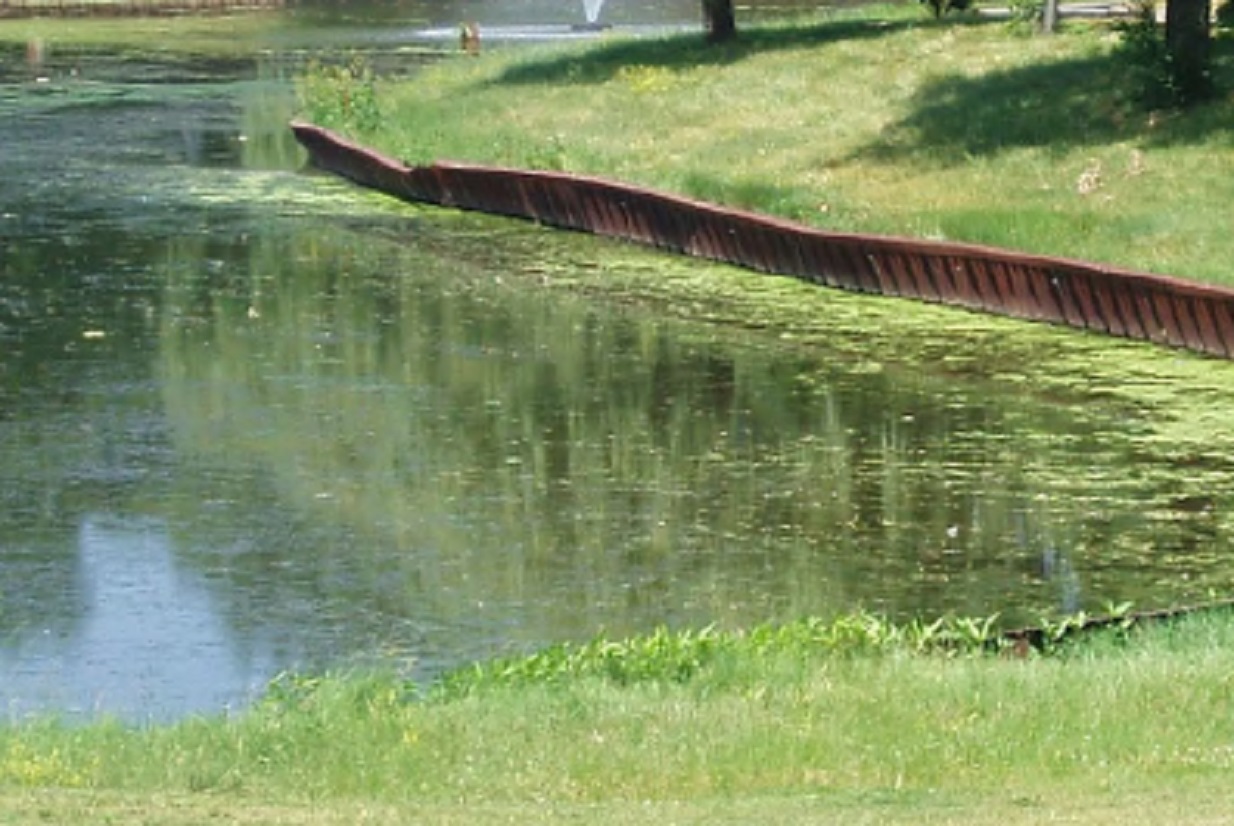

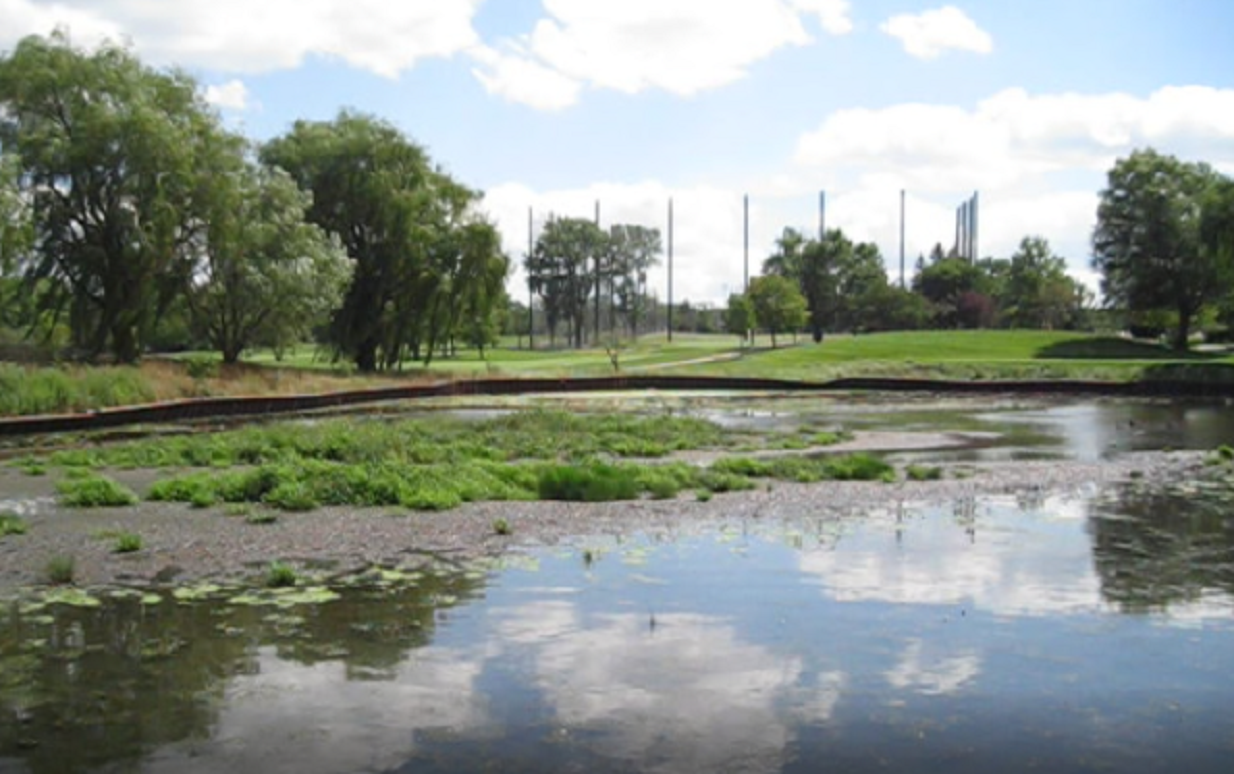

Sugar Creek Golf Course concerns, including exposed mud flats and sheet pile heaving
